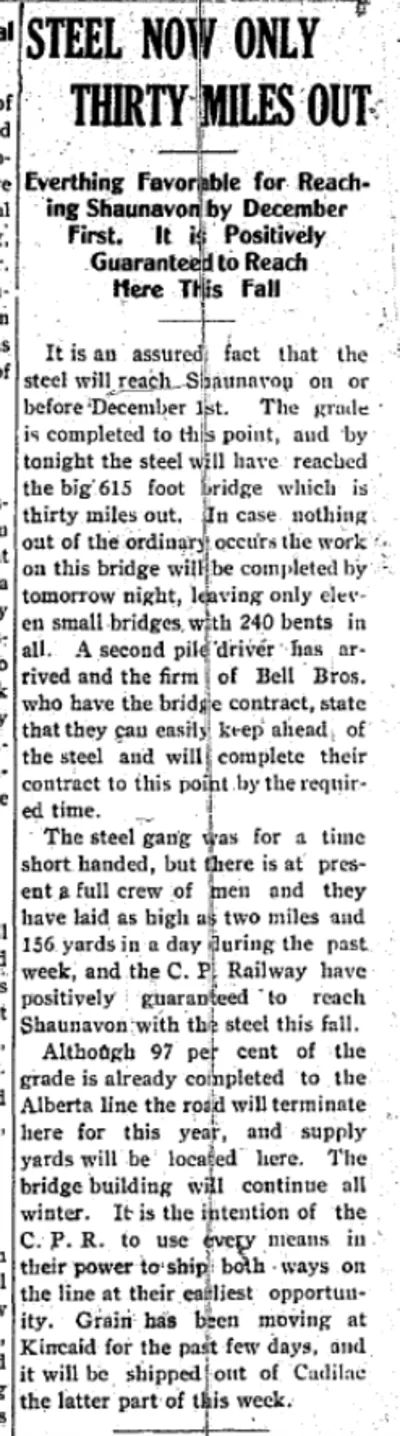

STEEL NOW ONLY THIRTY MILES OUT
Everything Favorable for Reaching Shaunavon by December First. It is Positively Guaranteed to Reach Here This Fall.
It is an assured fact that the steel will reach Shaunavon on or before December 1st. The grade is completed to this point, and by tonight the steel will have reached the big 615 foot bridge which is thirty miles out. In case nothing out of the ordinary occurs the work on this bridge will be completed by tomorrow night, leaving only eleven small bridges with 240 bents in all. A second pile driver has arrived and the firm of Bell Bros. who have the bridge contract, state that hey can easily keep ahead of the steel and will complete their contract to this point by the required time.
The steel gang was for a time short handed, but there is at present a full crew of men and they have laid as high as two miles and 156 yards in a day during the past week, and the C.P. Railway have positively guaranteed to reach Shaunavon with the steel this fall.
Although 97 per cent of the grade is already completed to the Alberta line the road will terminate here for this year, and supply yards will be located here. The bridge building will continue all winter. It is the intention of the C.P.R. to use every means in their power to ship both ways on the line at their earliest opportunity. Grain has been moving at Kincaid for the past few days, and it will be shipped out of Cadillac the latter part of this week.
